Your Water, Our Work

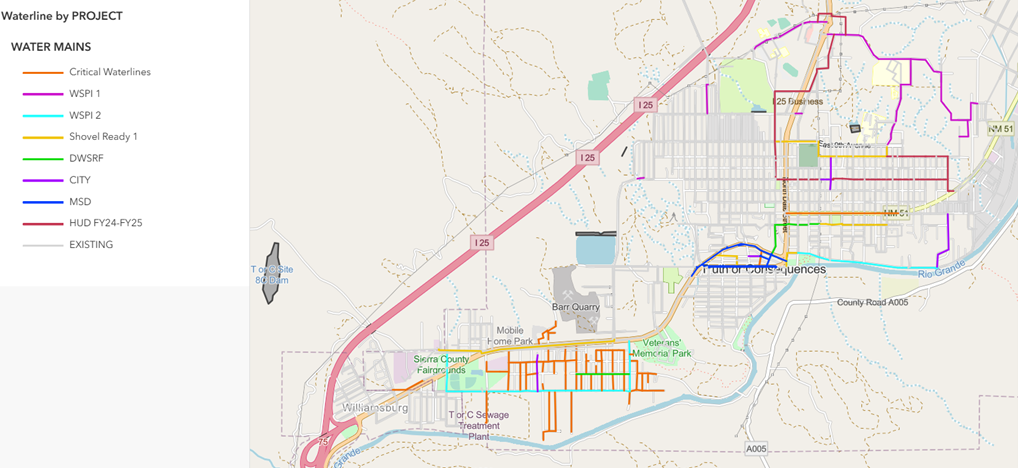

City map of comprehensive water projects:

Map of water projects
Primary focus for the projects listed above:
Critical Waterlines Prevent leaks in the "metal" streets areas (e.g. Aluminum Street).
WSPI-1 Pressure valves; gain and maintain water pressure.
WSPI-2 Creates a redundancy loop to prevent Williamsburg from losing service when repairs are made. Focus is on Veater Street and East Riverside. With additional funding, a line was added near Conoco.
Shovel Ready Combine small lines from other projects where funding shortfalls.
DWSRF Drinking Water State Revolving Fund for 2nd Street to South Pershing and Marshall Street completed October 2024.
City Lines the city funded for extreme issues on Pine Street, Arrowhead, and multiple line breaks on the "metal" streets.
MSD Downtown water lines completed mid-2025. Cook Street treatment plant completed in December 2025.
HUD FY24-25 Partially awarded; funding not finalized. Creates a second redundancy loop at the schools to remove majority of the cast iron lines.

The city will replace approximately 80,000 feet of waterline over the next 2-4 years, at an estimated cost of $40-50 million. Below are four current and upcoming projects.

Shovel-Ready Waterlines (construction started Jan 16, 2026)

What it is: A fast‑track bundle of line replacements pulled from other phases so crews were able to start quickly and capture funding sooner.
Scope: ~16,997 linear feet across six sections, including S. Broadway (Cook→Morgan) and McAdoo & Daniels (Main→N.).
Why: Speeds visible progress, cuts administrative delays, and reduces leak‑prone segments sooner.
Status: Work began in the 9th Street area on January 16, 2026; contractor schedule is posted on the project page and may shift with field conditions. Visit torcnm.gov/shovelready.


WSPI‑1: Pressure & Priority Line Replacements
What it is: WSPI‑1 focuses on pressure stabilization and targeted pipe replacements.
Key fixes:
  • Install 8 Pressure‑Reducing Valves (PRVs) (e.g., Kopra; Date & Pershing; 9th; N. Silver; Holden Rd. area; Broadway & Corona; S. Broadway near Veterans Memorial Park; Pershing & 8th).
  •Replace ~15,017 ft of aging pipeline in eight segments (e.g., New School Rd., N. Date, Yucca Heights Rd., E. Marie, Holden Rd., Kopra, W. 6th).
Why: Stable pressure prevents bursts, reduces leaks, and extends the life of pipes and fixtures.
Status: In bid advertisement process.


WSPI‑2: Veater & Riverside—Fixing the Most Leak-Prone Areas
What it is: Priority replacements on Veater St. and Riverside Dr., where crews respond to frequent mainline leaks. Includes hydrant upgrades and creating a redundancy loop so crews can isolate breaks without shutting water to larger areas (helping nearby Williamsburg).
Why: Fewer emergency shutoffs, better road conditions (less dig‑patch‑repeat), and more reliable service.
Status:Finalizing bridge loan - Ready to bid.


Smart Water Meters (AMI): Real‑Time Reads, Faster Leak Alerts
What’s changing: Installing Landis & Gyr AMI meters and is expanding the network by installing additional routers. Engineers will integrate AMI into current and future projects.
Funding path: The City acquired a CDBG grant to install 900–1,000 meters in the next 12–18 months, with a second phase funding request in planning for another ~1,000 meters; goal is full conversion over four years.
Why: More accurate billing, faster leak detection, fewer surprises, and time‑savings for field crews.
Status: In bid advertisement process.
